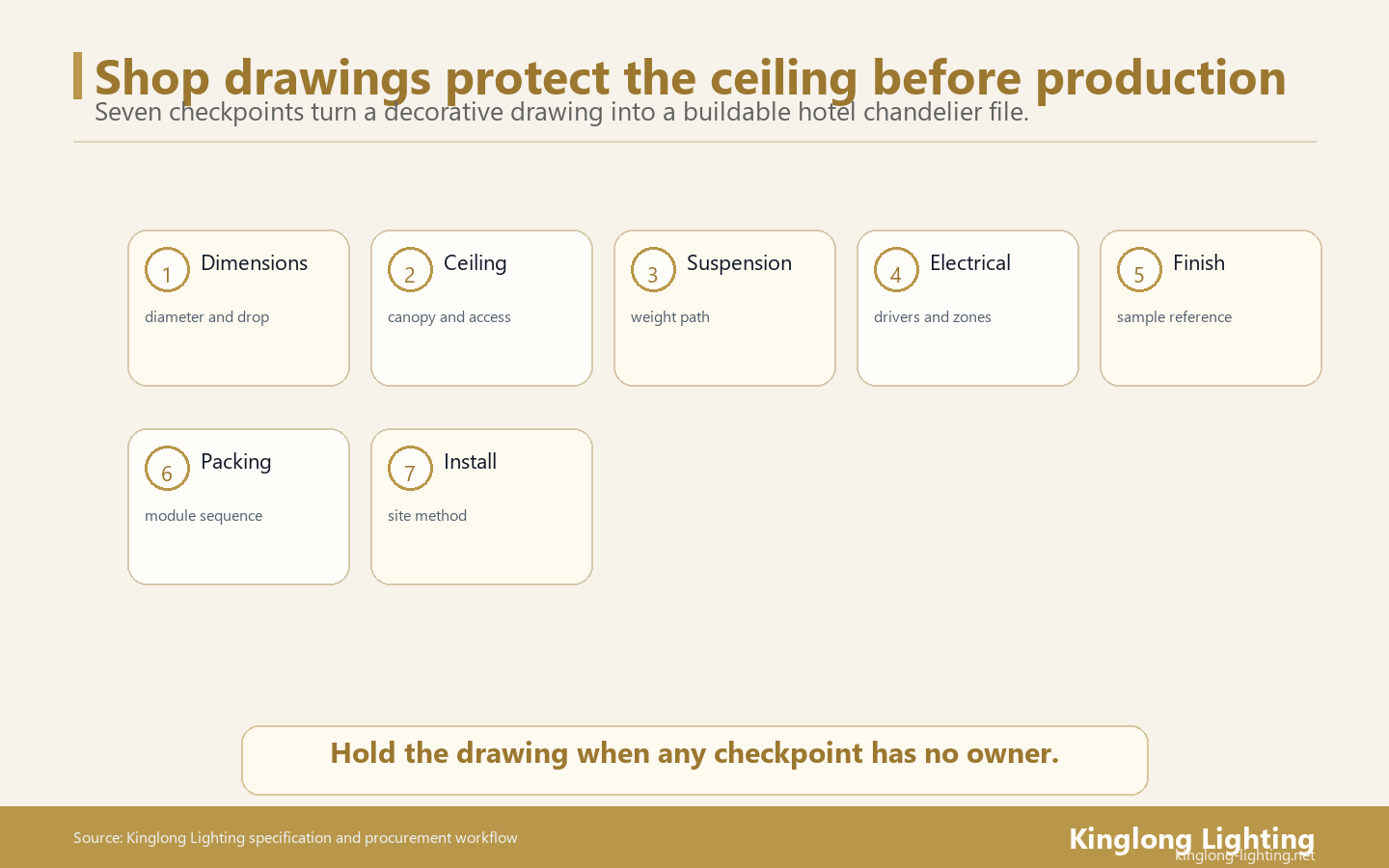

Review a hotel chandelier shop drawing by checking the document revision, dimensions, suspension interface, electrical equipment, controls, appearance and installation access. Record every unresolved item against a drawing reference, assign the person who can answer it and check the revised evidence before releasing the affected work.

The lighting manufacturer supplies fixture construction information. The project’s structural, electrical and installation professionals assess the interfaces within their respective scopes. Agree those responsibilities and the release authority at the start of the review.

Which drawing issues should hold the affected work?

Keep an issue open when its answer can change the fixture construction, building connection, electrical configuration or installation method. Identify the work it affects so the supplier can distinguish a production dependency from a later documentation update.

  • Check each fixture against the current design and coordinated building information.
  • Write a specific question and request the drawing, sample or technical evidence that would resolve it.
  • Record who reviewed the answer and the revision used for the release decision.

1. Confirm the fixture reference and drawing revision

Start with a drawing register that identifies the fixture reference, room, quantity, drawing number, revision and review status. Match that record to the lighting schedule and the relevant architectural or reflected ceiling plan. A changed room layout or ceiling revision can make an otherwise detailed fixture drawing unsuitable for its intended location.

Ask the manufacturer for the views needed to understand the design. A plan establishes the footprint and orientation. An elevation or section shows the body and suspension. A connection detail shows the proposed interface. Use the drawing legend to distinguish overall dimensions, installation dimensions and dimensions that still require site confirmation.

When a supplier reissues a sheet, compare the changed area and the related schedule entries. A revised canopy can affect fixing positions, cable exits and access even if the visible chandelier shape is unchanged. Record the related sheets that also need review so the team avoids closing one comment while leaving an inconsistent detail elsewhere.

2. Check the dimensional chain against the room

Separate the chandelier body’s dimensions from its total drop and the final position of its lowest element. Read each vertical dimension from an identified datum, such as the finished ceiling or finished floor. Ask the designer to confirm the intended position using the actual room section and project requirements.

Check horizontal location as well. Mark the chandelier centre or reference axis against the ceiling grid, furniture layout, stair opening or architectural feature it serves. For an asymmetric composition, establish its orientation in the room. A drawing can contain the correct overall width while showing the assembly facing the wrong direction.

List the surrounding elements that need coordination, including sprinklers, diffusers, detectors, access panels and nearby finishes. Ask the responsible design team to determine the applicable clearances. Where a dimension depends on completed site work, record how it will be measured, who will supply that measurement and which fabrication decision depends on it.

For additional project preparation material, use the lighting design and procurement resources alongside the current project drawings. Keep the review record tied to the fixture and location under consideration so a general guide supports a specific question.

3. Resolve the suspension and building interface

Request the proposed fixture weight, suspension arrangement, fixing layout and connection detail from the manufacturer. Identify whether the weight is preliminary or final and what assembly it includes. The structural reviewer needs enough information to assess how the proposed fixture connects to the actual building support.

Show the transition between the chandelier assembly, suspension components, canopy and building connection. Assign responsibility for the building-side support, site fixings, any secondary restraint and installation procedure according to the project scope. A manufacturer’s drawing can define its own connection arrangement while the building-side design remains a separate coordinated deliverable.

For a modular chandelier, ask whether the drawing describes the completed assembly or an individual module. Confirm the quantity and positions of suspension points, the installed orientation and any assembly sequence that changes how the installation team handles the fixture. Have the responsible professionals resolve missing loading or fixing information before the work depending on it proceeds.

4. Identify the electrical assembly and service location

Check the supply information, light source, driver or transformer model, electrical load and connection arrangement against the project electrical design. Distinguish the incoming building supply from the internal equipment arrangement. Ask the supplier to label terminals and identify the equipment included in its scope.

Lutron’s driver FAQs distinguish control interfaces by driver family. Lutron driver compatibility guidance

That example illustrates why the reviewer should record an actual model and its technical information. Ask the electrical designer to review the proposed driver with the intended light source and control equipment. If a substitute is offered, document the changed model and the associated information needed for review.

UL’s marking and application guides help users assess certified equipment for a particular installation using its markings and certification information. UL marking and application guidance

For the project, request the product documentation that its compliance reviewer requires and connect it to the proposed fixture configuration. Include the driver location, access method and replacement approach on the coordinated detail. The maintenance team should be able to identify the equipment and reach the serviceable parts through the agreed access route.

For a configuration reference, the Crystal Tube collection shows different forms within a decorative lighting family. When reviewing a selected configuration, trace its specific dimensions and equipment back to the drawing package used for the quotation and manufacturing discussion.

5. Match the dimming and control information

Replace a general “dimmable” note with the proposed interface and the information needed by the controls specialist. Identify the driver model, connection diagram, control-system interface and any functional expectations that influence selection, such as scene transitions or low-level operation.

DALI Alliance guidance describes component certification and luminaire-configuration conditions for use of the DALI-2 logo. DALI luminaire and component guidance

Where the project specifies DALI, ask which components are proposed and check their applicable records with the controls team. Treat a component change as an explicit drawing or submittal revision. The review should let the team identify the proposed combination and decide what compatibility evidence or testing it needs.

Agree how the intended behaviour will be checked. An illuminated sample or coordinated mock-up may help the team review the chosen assembly before the wider installation. Record the tested equipment and settings, the observed behaviour and the person accepting it. If a result leaves a question unresolved, state the further action and the scope that remains dependent on it.

6. Connect the drawing to approved materials and samples

List the material and finish references on the drawing so the visible assembly can be matched to its approved samples. Identify crystal or glass elements, metal finish, surface appearance and any diffuser or decorative component that affects the design. Attach the sample reference and approval record to the relevant fixture entry.

NIST’s metamerism definition explains that spectral differences can become apparent under different illumination conditions. NIST definition of metamerism

When reviewing materials, record the lighting and viewing conditions used for the approval. Where several materials are meant to work together, let the design team view that combination under relevant conditions. A rendered finish description, photograph and physical sample serve different purposes, so name the reference being approved.

Ask how the selected sample is identified through manufacture and final inspection. If the design team changes a finish or material, update the drawing reference and check the parts or assemblies it affects. Give a supplier’s proposed substitute its own recorded decision so the production team can determine which specification applies.

7. Review assembly, access and the handover information

Check how the fixture reaches its final position, how its modules are identified and how serviceable parts can be accessed after installation. Request the proposed assembly sequence, relevant handling information, labelled connection details and instructions available to the installer. Coordinate those inputs with the actual site access and installation plan.

WBDG commissioning guidance includes submittals, as-built drawings, operations and maintenance information, and issue-resolution records in the systems-documentation process. WBDG commissioning documents guidance

Use that documentation approach to decide which fixture records the hotel will receive. Agree the final drawing revision, component identification, approved material references, maintenance instructions and relevant inspection or functional-check records. Assign the party who assembles the package and the person who accepts it for the owner.

Review relevant installed work when discussing the proposed assembly and support scope. The Kinglong project portfolio provides a starting point for a project-reference discussion. Request information appropriate to the fixture scale, destination and service requirements being reviewed.

Copy this shop drawing review record

Use one row for each question that needs a response. Add the fixture reference, room, drawing number, revision, review date and reviewer names above the table. Keep the original question visible when recording the supplier’s answer, then identify the revised evidence used to close it.

Four stages link a marked drawing issue to evidence review and an issue-specific recorded decision
Record the revised evidence and reviewer decision for each issue before treating it as closed.
Issue reference Drawing location and observation Response or revision requested Responsible party Status Evidence and closure
Reviewer assigns a unique issue ID Record the sheet, detail and conflicting or missing information State the drawing, calculation, sample or document needed Name the party supplying the answer and the reviewer Record Open, Response received, Closed or Further action for this issue Record the response revision, reviewer decision and date

Use the project’s agreed review terms on formal submittals. For the working log, define what each status means. “Response received” indicates that information has arrived. Closure records the reviewer’s decision and the evidence used. Where a comment affects fabrication or installation, identify that dependency in the release note.

A fictional review example with an unresolved ceiling interface

In this fictional example, fixture L-07 is intended for a hotel lobby. The design brief requests an overall drop of 3,200 mm. Drawing revision B labels a 1,200 mm body and a 3,200 mm suspension length. The reviewer records that the dimensional chain leaves the intended bottom position unclear.

The same drawing shows a canopy connection but omits the proposed fixture weight. The ceiling support detail is still under coordination. The review team opens two separate issues because one concerns fixture geometry and the other concerns the building interface.

Issue Requested action Review evidence Decision
SD-01, total drop unclear Manufacturer to distinguish body height, suspension length and overall drop from the agreed ceiling datum Revision C shows the intended overall drop and a coordinated section Designer checks the bottom position and records dimensional acceptance
SD-02, support information incomplete Manufacturer to provide fixture weight and connection information for the structural reviewer Weight information is received, while the building connection detail remains under review Keep the support-dependent work open until the assigned reviewer confirms the interface

The revised dimension closes SD-01 when the designer checks it against the lobby section. Receiving weight information advances SD-02, but the team still needs the building-side answer. The release record identifies which work depends on that answer. These dimensions illustrate the review method and carry no prescribed clearance or loading criterion.

Send a coordinated question to the manufacturer

Kinglong Lighting manufactures decorative lighting for overseas projects and supports custom fixture development. For a hotel lighting manufacturing discussion, send the current drawing, fixture schedule, marked review comments and project destination. Identify the information already agreed and the questions requiring a manufacturer response.

Frequently asked questions

Who should review a custom hotel chandelier shop drawing?

The review should involve the people responsible for design intent, fixture manufacture and the building interfaces affected by the proposal. The interior or lighting designer checks appearance and positioning. The manufacturer answers fixture-construction questions. Structural, electrical, controls and installation reviewers handle their assigned interfaces. The project team should agree who records comments and who can authorise the affected work.

Can part of the chandelier package proceed with an open comment?

A partial release depends on the project team’s agreed authority and a clear separation of the affected work. Record the open issue, the work depending on it and the scope proposed to proceed. Ask the manufacturer to identify dependencies across components before the team makes that decision. A broad acceptance note can obscure those dependencies, so the release record should identify its actual scope.

What should happen when a driver or material changes after review?

Record the proposed change against the fixture reference and identify the earlier review decisions it affects. Request revised technical information, drawings or samples as appropriate. Have the responsible reviewer check the changed configuration and update the relevant approval record. Retain the earlier revision so the team can trace why the decision changed and which specification manufacturing should follow.
