A lighting bid compliance matrix should compare each supplier against the same issued requirement, the exact product offered and evidence that supports the response. Keep technical pass, demonstrated failure and unresolved evidence separate before ranking prices. For a hotel procurement team, the useful result is not a percentage of boxes completed: it is a defensible explanation of which offers meet the required scope, which depart from it and what the tender procedure allows the team to do next.

Set the Same Tender Baseline for Every Bid

Use the same issued requirements and evaluation rules for every bidder. Identify the specification revision, fixture schedule, drawings, issued addenda and commercial instructions before extracting rows. If these documents disagree, refer the conflict to the designated project authority; do not quietly choose the wording that makes a preferred offer appear compliant.

Mark which obligations are mandatory, which are scored preferences and which require later design development. Derive those categories from the tender, not from a reviewer’s personal ranking. A deviation is a declared departure from an issued requirement. A supplier’s silence is neither acceptance of that requirement nor permission to change it.

For US federal sealed bidding, FAR 14.301 requires a bid to comply in all material respects with the invitation to be considered for award.

That is a specific public-procurement rule, not a universal rule for private hotel tenders. Its relevance here is the distinction between satisfying the required offer and presenting an attractive price. Your project’s procurement documents determine eligibility, permitted clarifications and award authority.

Give procurement ownership of the baseline and response register, with named technical reviewers for lighting performance, decorative appearance and installation interfaces. Record the due date for each review. A commercial buyer can coordinate the decision without pretending to resolve an electrical or structural question outside their authority. Where bids are already submitted, preserve their original wording when mapping them into the common format.

Build the Clause-Level Comparison Before Reviewing Offers

Extract obligations before asking bidders to respond. The next step is to turn the issued specification into independently reviewable statements, then give every supplier the same response fields. This makes omissions visible without adding new acceptance criteria after the competition has started.

Turn Decorative Lighting Specifications into Testable Rows

Separate appearance, measurable performance and interfaces so one answer cannot hide another failure. An illustrative clause such as “bronze wall light with the scheduled output, dimming and accessible driver” contains several obligations. Finish evidence cannot prove output; a driver datasheet cannot show that the installed driver will be accessible.

For each resulting row, retain the original clause reference and state the acceptance basis: an approved finish reference, a specified measurement, an interface drawing or a defined demonstration. If the tender says only “high quality” or “suitable dimming,” flag the ambiguity through the project’s clarification process. Do not manufacture a numeric threshold to fill the cell.

The IES public description of LM-79-24 covers measurements including light output, electrical power, intensity distribution and color under standard conditions.

This scope helps distinguish measured lighting performance from appearance evidence. It does not supply this project’s pass limits or certify visual suitability in a hotel room. Where the specification requests that method, ask for the applicable results and tested configuration; retain the project’s own acceptance criteria beside them.

A Lighting Bid Compliance Matrix You Can Reuse

Keep supplier response, supporting record and reviewer status in separate fields. A useful matrix connects one requirement to what is offered and why the reviewer reached a finding. If evidence is absent, the status remains unresolved; a supplier-entered “yes” is not a verified pass. This separation also preserves the original response when a later clarification changes the reviewer’s conclusion.

The following field structure can be used in a spreadsheet or procurement system. Maintain one record per requirement and bidder, or repeat the response fields beside the common requirement columns. Do not compress several bidders’ documents into an unlabeled evidence cell.

Reusable fields for a clause-level lighting bid comparison
Field group What to record Review purpose
Requirement Row ID; clause and revision; fixture type; acceptance criterion; mandatory or scored status Keep the evaluation tied to the issued obligation.
Offer Bidder; offer revision; exact model or custom configuration; offered value Identify what the quoted price actually buys.
Evidence Document or sample ID; revision; page or result; applicable configuration Allow another reviewer to locate and check the same proof.
Departure Declared difference; affected requirement; related technical or commercial consequence Expose a changed obligation instead of burying it in notes.
Review Pass, fail, pending or justified not applicable; reviewer; finding date; reason Distinguish a supplier declaration from an evaluated result.
Closure Responsible person; permitted next action; due date; required evidence; final disposition Make an open issue actionable and preserve its outcome.

For example, an illustrative finish row could reference the scheduled bronze finish, identify the offered sample and record “pending: sample reference missing.” Its closure requires the designated appearance reviewer to check the identified sample against the issued reference. “Send better pictures” is weaker because it leaves the required comparison undefined.

Verify That the Evidence Covers the Offered Configuration

Map each configuration to applicable evidence rather than extending a family claim by assumption. Record the light engine, driver, control option and other identity details relevant to the clause. For custom products, connect the offer to a drawing revision or configuration schedule when a catalogue model number alone is insufficient.

A report may cover more than one configuration, but the reviewer needs the documented basis for that coverage. Check the tested item and stated scope, then request an explanation of any differences that could affect the result. Neither “same series” nor a familiar laboratory logo resolves that question.

The DALI Alliance database ties certification to the tested product and matching brand, GTIN, firmware, hardware and product ID; luminaires are not listed in that database.

A Global Trade Item Number (GTIN) identifies the trade item; the other identifiers further constrain the product record. When a bid specifies certified control gear, check that record against the offered component. Do not turn component certification into a claim that the complete decorative luminaire or installed control system is approved.

UL describes Product iQ as a database for verifying the UL certification of a product or component.

If UL evidence is required by the tender, use the relevant product or component record and its actual scope, not a supplier’s general list of certificates. Record who checked it and what was checked. These resources identify verification routes; they are not evidence that a particular Kinglong offer holds the required certification.

Distinguish a Failed Requirement from Missing Evidence

Treat compliance, noncompliance and unresolved evidence differently within the tender procedure. Use “pass” when the required evidence supports the offered value. Use “fail” when the evaluated offer departs from the requirement. Use “pending” when the available record does not yet support a finding, and “not applicable” only with a documented scope reason.

Pending is a review state, not an entitlement to another submission or a conditional technical pass. A mandatory row that remains unresolved at the decision deadline must receive the disposition required by the tender rules. Do not average it together with passed rows to produce an apparently acceptable compliance score.

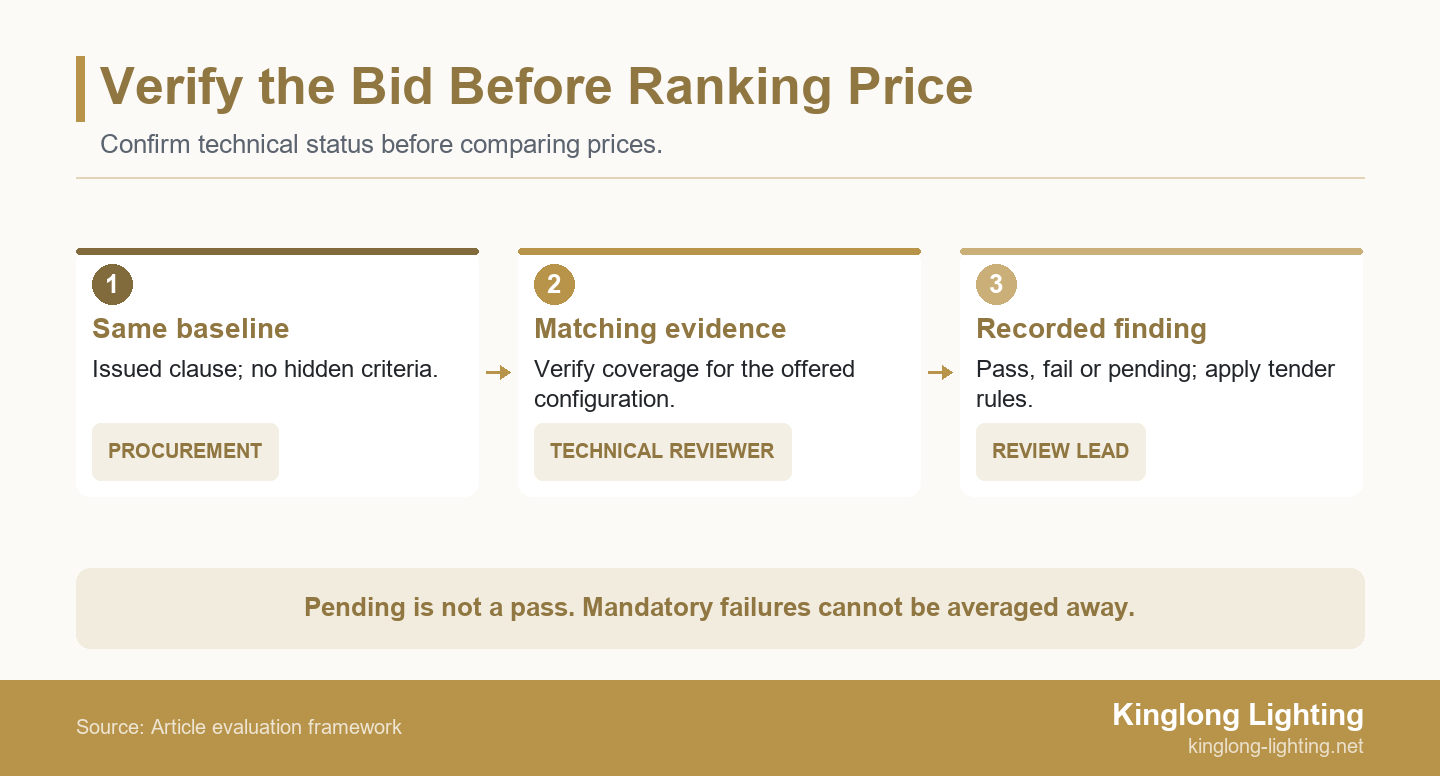

Bid review gates show shared requirements, matching evidence and technical status before price comparison.
A price comparison cannot turn missing evidence into technical compliance. Apply the tender rules to each unresolved or failed requirement.

FAR 14.405 distinguishes minor matters of form from substance and permits correction or waiver without prejudice to other bidders within US federal sealed bidding.

That narrow procedural distinction is not permission to repair a material departure, and it does not govern every private tender. Ask the responsible procurement authority whether the proposed clarification is allowed. Record the question, response deadline and effect on the finding; do not let a technical reviewer negotiate a changed offer informally.

Compare Prices Only Against a Defined Scope

Compare obligations and costs together without repairing a disallowed technical deviation. A lower fixture price may exclude drivers, mounting components, spare parts, mock-ups, delivery stages or commissioning attendance that another bidder includes. Map these differences to the stated procurement scope before calling either offer less expensive.

Keep the original quoted amount intact. Where the evaluation rules permit adjustments, show each adjustment separately with its basis, owner and supporting quotation or rate. If an excluded obligation has no defensible cost, label the comparison incomplete rather than inventing an allowance. A commercial adjustment is not authority to accept an otherwise ineligible technical offer.

CIBSE’s public LG20 overview concerns maintaining, modifying and updating lighting installations, and its contents include suggested material for operations and maintenance manuals.

That published scope is a useful reminder to examine handover obligations, not just delivered hardware. The public overview does not prescribe this tender’s deliverables. Check whether the requested manuals, component identification, maintenance instructions and spare-parts information are included in each offer, and who must assemble the final package.

Also separate an offered dispatch date from arrival at the project and readiness for installation. If a delivery commitment depends on drawing approval, identify that dependency against the programme. A supplier’s shorter stated lead time is not comparable with an unconditional date until the starting event and included logistics are understood.

When One Missing Record Affects Several Fixture Types

Trace the gap across all offered configurations before limiting its impact. One missing attachment reference may look like an administrative detail, but the real question is how many bid items rely on evidence that has not been connected to them.

Illustrative Example: 180 Wall Lights Across Six Configurations

An FF&E buyer compares 3 bids for 180 wall lights in a hotel. One bidder offers 6 configurations, marks the performance rows compliant and attaches 1 report without mapping it to those configurations. This illustrative example is not a Kinglong tender or a claim about an actual supplier. The quantities describe the scope of the review, not industry failure rates.

At first, the reviewer flags the attachment as a single documentation issue. Once the matrix is filtered by configuration, no offered configuration has a traceable link to that report. The pending scope therefore covers all 6 configurations, not merely the attachment row. The buyer keeps the affected offer pending rather than placing it in the technically passed price comparison. This finding does not establish that all the products would fail a test.

Reduce the pending scope only where evidence mapping has actually been verified. The clarification establishes applicable coverage for 2 configurations; the other 4 remain unsupported. The reviewer updates those individual rows without marking the whole package passed. Whether the tender allows further clarification or a partial award is a separate procurement decision. No unit quantity is released from the 180-light package merely because two configuration mappings have been verified.

Issue a Bid Recommendation with Traceable Exceptions

Carry the accepted offer, exceptions and scope assumptions into the award decision. The recommendation should identify the evaluated bid revision, the technical reviewers’ findings, the authorized commercial comparison and any outstanding decision reserved to the approving authority. A green summary cell is not an adequate substitute for that record.

Before recommending award, reconcile the summary with the detailed rows. Check that no unresolved mandatory requirement has disappeared from the shortlist, that accepted departures have the required authority and that quoted exclusions match the scope used for price comparison. Preserve superseded responses so another reviewer can follow how the conclusion changed.

Then attach or reference the final configuration schedule and accepted clarification record in the award documentation through the project’s contract process. Avoid leaving the selected bidder’s original generic “all compliant” statement as the only description of what was evaluated. The procurement team needs an identifiable offer that later submittals can be checked against.

Frequently Asked Questions

Should every specification sentence become a separate row?

No. Split independently verifiable obligations, but keep a simple requirement together when it shares one acceptance test and evidence source. Excessive splitting creates duplicate findings and obscures ownership. Preserve a link to the original clause so reviewers can check that the extraction has neither dropped a condition nor added one.

Can confidential test reports be accepted without copying them into every bid file?

Only through a controlled review method allowed by the project, with enough retained identification to show what was checked. Record the report reference, scope, reviewer, access date and finding. Confidentiality should govern access and retention; it should not prevent the authorized evaluator from examining the evidence needed for the decision.

How should an alternative offer appear beside a compliant base bid?

Keep it as a separately identified offer, if alternatives are permitted, so its departures and price cannot be confused with the base bid. Identify the route for evaluating the alternative and retain both response sets. Any design alternative must be legitimate; a specification reference does not authorize copying protected designs.

Does a compliant bid remove the need for later submittal review?

No. Bid evaluation and later submittal review serve different decisions; the contract determines what still needs approval before manufacture or installation. Carry the accepted bid configuration into those reviews. If the supplier later changes a component or detail, assess that change through the applicable procedure rather than assuming the earlier finding covers it.
